|
    I really hadn't
      planned to build my own roof trusses.  After all, there are plenty of
      truss-building companies around.  But I soon learned that they only
      build wood trusses, and that just wouldn't do. In my quest
      for a supplier, I met and became friends with Gary, the owner of a wood
      truss yard in nearby Oceanside.  Gary granted me the use of his
      facility to build my trusses.  I packed up my cutoff saw and table
      and spent most of the summer of 1997 there.  |
     |

     |

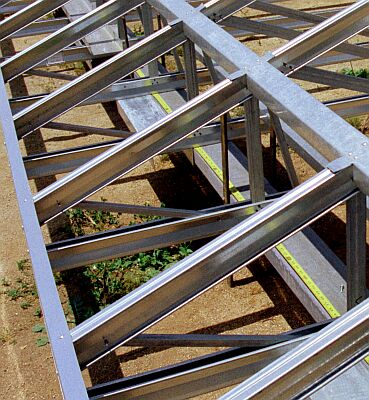

    One advantage steel has over wood is
      availability in very long pieces.  This and some careful planning

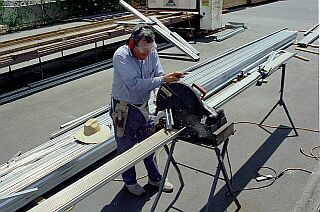

      will minimize scrap.  The material from which I built the trusses
      came in 40-ft lengths.  One piece weighs only about 65 pounds, but
      it's very hard to turn while holding it. |
      |

     |
    I would need a precise cut list to minimize
      scrap, but first I had to design the trusses.  I turned to DesignCAD,

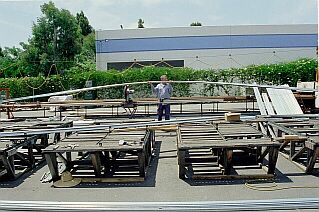

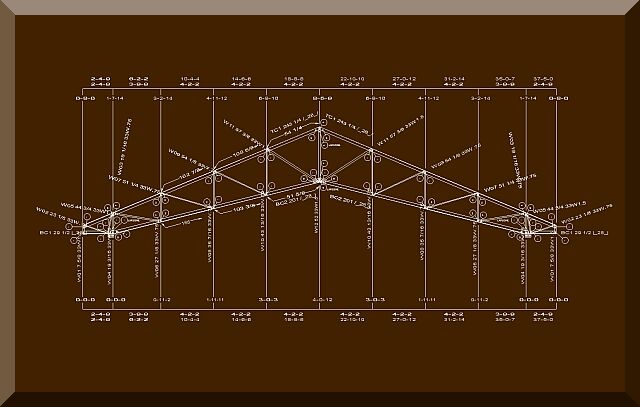

      which I use for almost everything, and prepared a dimensioned drawing for
      each of the 128 trusses.  These drawings were then given to Gary's
      staff who ran the engineering and produced signed drawings for the county
      building department to approve. |
      |

    |  I wrote a simple program to extract
      the precise length of each element from the DesignCAD file and place them in an Excel
      worksheet.  The worksheet sorted by length and I had my cut list.
      The cutting procedure was to cut the longest first and always try to find
      a near-size remnant to cut from.  After cutting was finished I had a
      large pile of very short scraps and a few remaining full-length pieces.
       The most difficult part was determining the length of the web
      elements.  I was never able to come up with a mathematical procedure
      for this,
      so each web was precisely sized by an iteration process.
     |
      |

     |

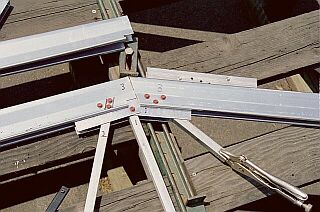

    The joints between webs and chords are fastened

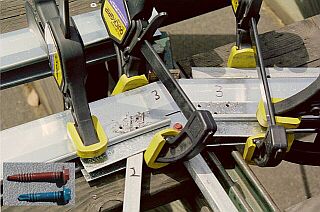

      with blue double-shear self-drilling screws like shown in the inset.
      When additional metal layers are involved, such as shown here for chord
      joints, the longer red double-shear screws are used.  But they often
      break from the added torque.  So I pre-drilled the holes for all the
      red screws. |

     |

     |
    I build the garage trusses first and decided to
      try setting them before building with the rest.  I
      was not yet accustomed to working at height, so I built a replica of the
      garage top plate two feet off the ground and assembled the roof structure
      on it.  When finished I hired a crane to lift the assembly into
      place. |
      |

     |
    The steel top plate constitutes a serious
      thermal bridge between inside and outside - not satisfactory for this
      energy-efficient house.  The solution was a change in the truss
      profile.
       Trusses for wood houses end at the outside edge of the plate.
      Drooping rafter tails continue the roof structure beyond the wall to form
      the overhang.  The rafter tail usually passes only 3-1/2 inches above
      the plate and the gap between roof sheathing and plate is filled with
      pieces of 2X4 called Frieze blocks.
      I changed the truss profile to be a structural cantilever beyond the
      plate.  This resulted in an 18" (instead of 3-1/2")
      heel-stand above the plate in which full-depth insulation could be wrapped

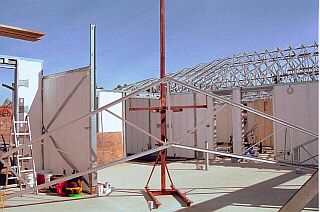

      around the plate into the soffit.  This requires special bracing to

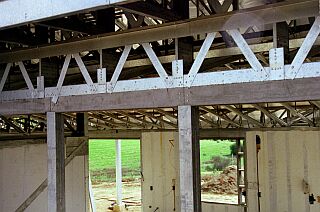

      properly transfer lateral forces to the walls, as shown in this photo.  |

         |

      |

     |
    By the time the garage roof structure was

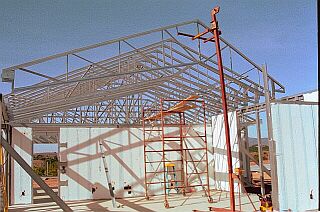

      fastened in place I was less apprehensive about working at height.  I
      decided to set the trusses individually for the rest of the house and save
      the crane fee.  I

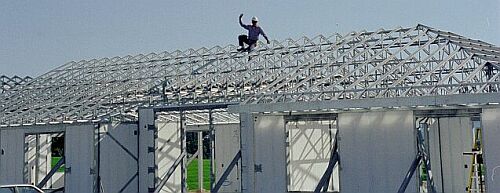

      made a lifting fixture for my beam hoist to raise the trusses, diagonally
      to the walls so they'd fit between them, then I'd rotate the hoist and

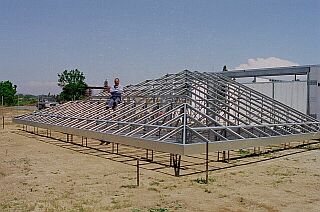

      lower the truss into position.  What was needed next was a trip up
      the rolling scaffold to secure the truss against the braced line of

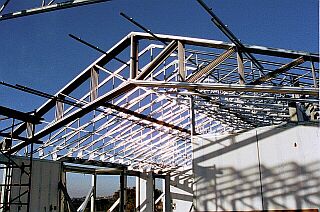

      trusses already in place. |

  |

     |
    Eventually I approached the point of insufficient
      clearance to raise the rotated truss.  So I stacked the rest and
      removed the hoist.  These had to be manually finessed into position
      moving each end a
      few inches at a time. |

  |

     |

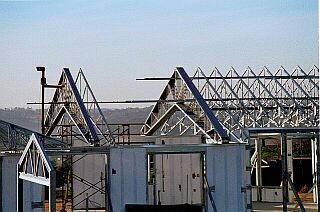

    By Christmas, 1997, the roof structure was in
      place.  There were still a lot of fasteners and ridge caps yet to
      install and, worst of all, the sheathing. |
      |

     |
    I suppose installing the sheathing was the
      worst chore of the whole project.  I'm astonished that I survived
      it.  To make it more challenging I laminated the underside of each
      heavy sheet with aluminum radiant barrier material to keep the attic
      temperatures lower.

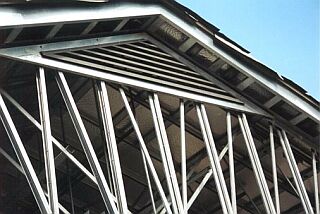

       One little feature that has been pleasing is this triangular gable
      vent.  I had it custom made, and it looks much nicer than the ugly
      rectangular ones on other houses around here.  |

  |
